Templates Guides
Construction Budget Template for Specialty Contractors


We're offering a free construction budget template built specifically for specialty subcontractors in HVAC, plumbing, electrical, and other trades doing construction work. It's designed around the way subs manage project costs, organized by project phase, crew type, and the materials and equipment your trade is responsible for. Available as an Excel template (also compatible with Google Sheets).
Click here to view the template and make your own copy.
What's Included in Our Free Construction Budget Template
Most construction budget templates you'll find online are built for general contractors. They organize costs by CSI division (concrete, framing, finishes, mechanical, electrical) because a GC is tracking the entire building. That structure doesn't map to how a specialty contractor budgets a job.
If you're the HVAC sub on a commercial tenant improvement (TI), you don't care about the concrete division or the framing package. You care about your ductwork fab costs, your refrigerant piping, your equipment procurement, your rough-in labor versus your trim labor, any selective demolition in your scope, and whether the insulation sub and controls sub you've hired are going to come in on budget.
This template is organized around that workflow. It tracks costs by project phase and trade-specific category, with columns for the financial data a sub actually needs to manage throughout a job.
Template Columns
Each row in the template represents a budgeted cost item within your scope. The columns track:
Cost Code — your internal code for that line item (e.g., RI-01 for a rough-in material, EQ-03 for an equipment item). Codes are prefixed by phase for easy sorting.
Description — the specific scope or work item (e.g., "Primary System Materials" or "Rough-In Labor")
Category — what type of cost it is: Labor, Materials, Subcontracted, Overhead, Permits, Change Order, Contingency, or Closeout
Budgeted Qty — the quantity you're budgeting for that line item (hours, units, lump sum)
Unit — the unit of measure (Hr, EA, LS, SF, Mo, BF)
Unit Cost ($) — your estimated cost per unit
Budgeted Amt ($) — auto-calculates from Qty × Unit Cost
Actual Cost ($) — what you've spent to date, entered as invoices come in or costs are incurred
Variance ($) — auto-calculates the difference between budgeted and actual (positive means under budget)
Variance (%) — the variance as a percentage of your budgeted amount
Invoice Status — Paid, Pending, Disputed, or Not Yet Billed
Date Incurred — when the cost was recorded
Notes — context for that line item: supplier details, PO references, variance explanations, scheduling notes
Cost Sections (Commercial Project Tab)

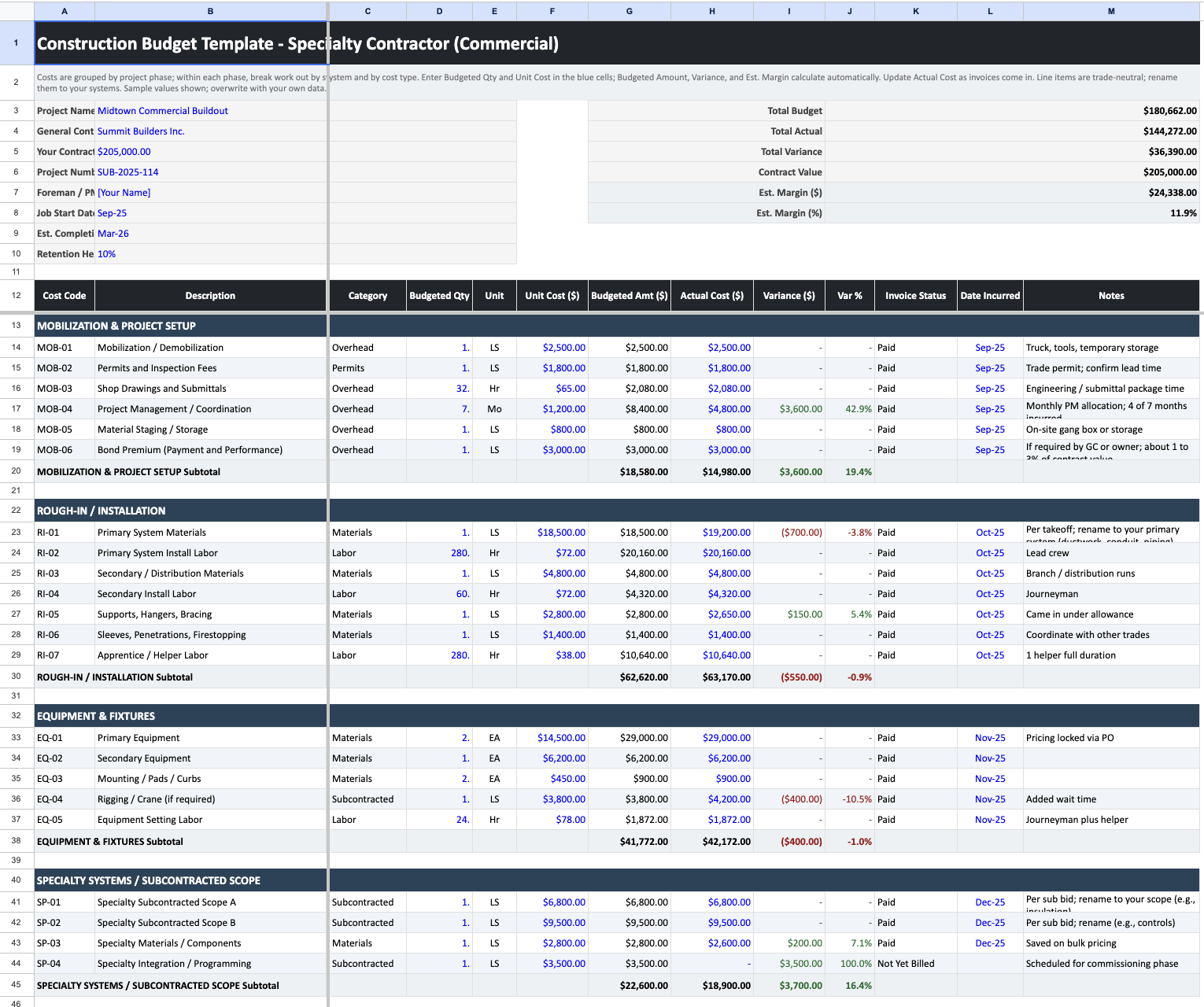

The commercial construction budget template tab comes pre-loaded with sample data for a commercial buildout with a contract value of $205,000. The line items are trade-neutral: rename them to match your systems (ductwork, conduit, piping, or whatever your trade installs) and adjust the quantities to fit your scope. The sample data is organized across eight cost sections, grouped by project phase:
Mobilization & Project Setup covers the pre-construction and site preparation costs you incur before any installation work starts: mobilization, permits and inspection fees, shop drawings and submittals, project management time, material staging, and bond premium if your contract requires one. These are the overhead and coordination costs that eat into margin if you don't budget them explicitly.
Rough-In / Installation is typically the largest section by both labor hours and material cost. It's split into your primary system (materials and install labor) and your secondary or distribution system (materials and install labor), plus supports and hangers, penetrations and firestopping, and apprentice or helper labor. Separating primary and secondary system costs, and journeyman labor from apprentice labor, gives you a clearer picture of your true labor cost per phase, no matter which trade you're in.
Equipment & Fixtures tracks procurement and installation of your primary and secondary equipment, mounting and pads, rigging or crane costs if equipment setting requires them, and equipment setting labor. Equipment pricing is often locked via purchase order well before installation, so this section lets you capture what's been committed versus what's been spent.
Specialty Systems / Subcontracted Scope covers work you subcontract out rather than self-perform, whatever that looks like for your trade (insulation, controls, low-voltage, or another specialty scope). The template tracks these as subcontracted line items with their own budget, actual cost, and invoice status, so you can see whether your subs are on track without lumping their costs into your own labor and material totals.
Trim / Finish covers the work that happens after ceilings and walls are closed up: trim materials, trim install labor, final connections labor, and any test-adjust-balance or equivalent subcontracted scope. This phase often gets squeezed when earlier phases run long, and having it budgeted separately makes the squeeze visible before it becomes a cost overrun.
Testing & Commissioning includes system pressure or function testing, performance or leakage testing, startup and commissioning, and punch list labor. Most subs don't budget punch list labor explicitly, and then they absorb that cost as unbillable time at the end of every job.
Change Orders tracks approved and pending scope changes with their own cost codes, so change order costs don't get buried in the original budget categories.
Warranty & Closeout holds your warranty reserve, as-built documentation time, and contingency funds. The sample sets contingency at roughly 5% of labor and materials. Adjust it based on your risk tolerance and how well-defined the scope of work is at kickoff.
The template header also tracks your contract value against the GC, retention percentage, and estimated margin, both in dollars and as a percentage of contract value. The sample project shows total budget coming in under contract value at an 11.9% estimated margin, a healthy but not padded number that's realistic on a lot of competitively bid commercial work.
Residential Project Tab

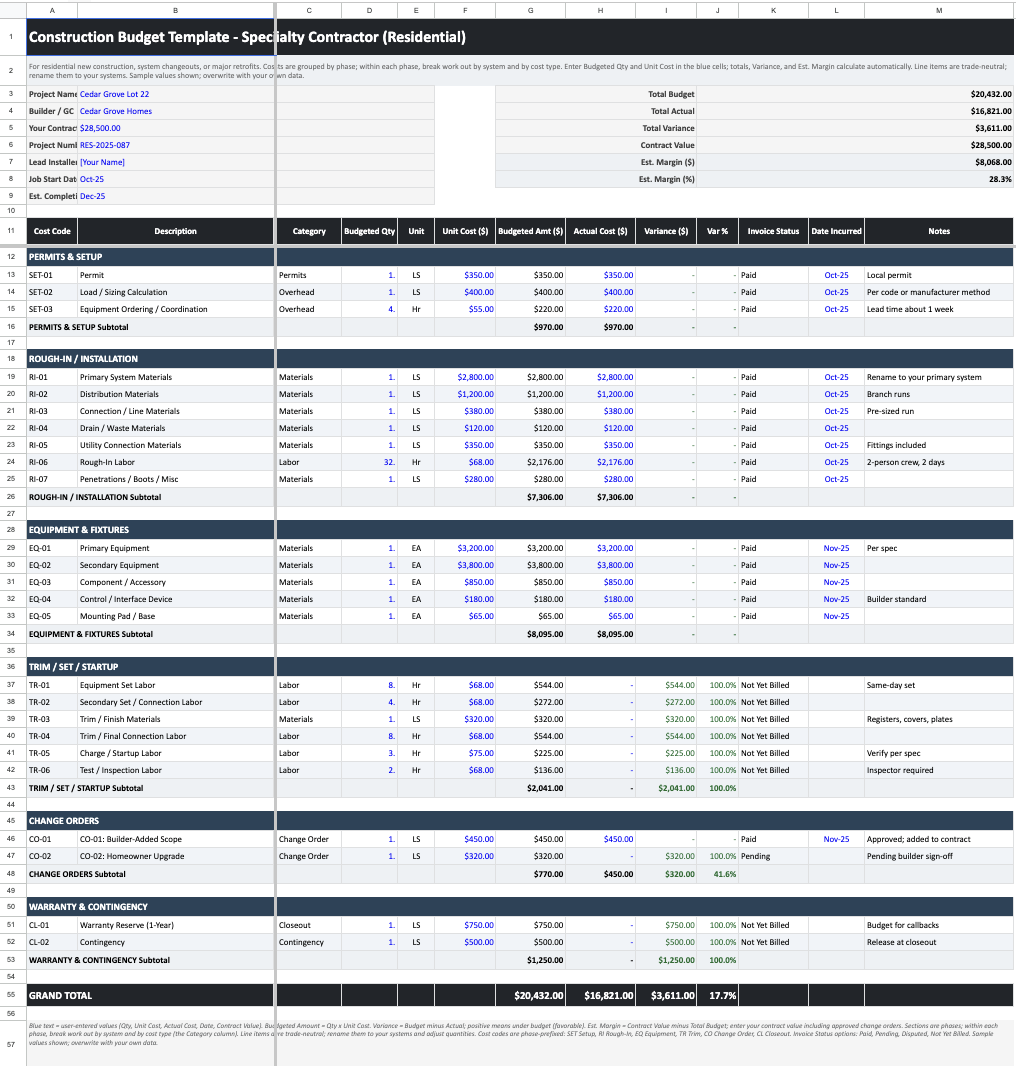

The residential construction budget template tab uses the same trade-neutral structure as the commercial tab, scaled down for residential new construction, system changeouts, or major retrofits. The sample data models a single-system install on a new-construction lot with a contract value of $28,500, and it's organized across six phases instead of the commercial tab's eight:
Permits & Setup covers your permit, the load or sizing calculation required by code or the manufacturer, and equipment ordering and coordination time.
Rough-In / Installation breaks out primary system materials, distribution materials, connection or line materials, drain or waste materials, utility connection materials, rough-in labor, and penetrations and other miscellaneous materials. As with the commercial tab, rename these line items to match whatever system you're installing.
Equipment & Fixtures tracks your primary equipment, secondary equipment, a component or accessory line, a control or interface device, and the mounting pad or base.
Trim / Set / Startup covers equipment set labor, secondary set and connection labor, trim and finish materials, trim and final connection labor, charge or startup labor, and test or inspection labor. This is where residential jobs bunch up their finish work into a single tight phase, since a residential install typically doesn't have the multi-week gap between rough-in and trim that a commercial project does.
Change Orders and Warranty & Contingency work the same way they do on the commercial tab, just scaled to residential dollar amounts, with a smaller warranty reserve and contingency line.
A residential system install on new construction is typically a two- to four-day job for a small crew, not a multi-month project with multiple subcontractors, and the sample data reflects that difference in scope and complexity. The header tracks the same fields as the commercial tab (contract value, retention isn't typically applicable on residential work, so that field is dropped), along with estimated margin in both dollars and as a percentage of contract value.
How to Use the Template
Start by entering your project information in the header block: project name, the GC or builder you're working under, your contract value, and your key dates. Then populate each row with your budgeted quantities and unit costs, pulled from your construction estimate or your bid workup.
As the job progresses, material invoices arrive, labor hours get logged, equipment is delivered, and sub invoices come in. Enter actual costs and update the invoice status column as each one hits. The variance columns are calculated automatically.
Review the budget at regular intervals. The end of each project phase, each billing cycle, or any time a significant cost hits are all good checkpoints. Use the notes column to document anything that needs context, whether that's a material price that came in higher than your estimate, a subcontractor invoice pending approval, or a labor overrun tied to a specific phase. That documentation matters when you're building your next estimate and trying to figure out where your assumptions were off.
Used consistently across projects, this template gives you a running record of where your costs stand relative to your original budget and your contract value, along with the documentation to support better estimates on the next job.
The #1 newsletter for the trades.
The Limitations of Managing a Construction Budget in a Spreadsheet
This free template is a useful starting point for construction cost tracking and financial planning. But if you've built and managed project budgets in Excel or Google Sheets across more than a handful of jobs, you've likely already run into the limitations, especially as your project volume grows and the gap between "what we budgeted" and "what we can actually see" gets wider.
Here are the problems specialty subcontractors hit most often.
1. Every Budget Starts from Scratch
Your estimate wins the job. Then someone (you, your PM, your office manager) manually rebuilds the budget in a separate spreadsheet. The estimate lives in one file or one system, and the budget lives in another. There's no connection between them.
That disconnect creates two problems. First, every budget is a manual re-entry of numbers that already exist somewhere else. Transposition errors, missed line items, cost codes that don't match. All of it is possible every time you build a new project budget from a blank template. Second, you have no way to pull from historical job data when you're building the budget. What did rough-in labor actually cost on your last three TI projects of similar size? You'd have to open three old spreadsheets and compare manually, assuming you can find them and the data was entered consistently.
A spreadsheet also can't reference your pricebook. If your material costs have shifted since you built the estimate (and on longer-lead commercial projects, they often do) the budget still reflects whatever numbers were manually entered at kickoff. There's no automatic connection between your construction cost estimating and the budget you're tracking against.
2. You Can't See Committed Costs
This is one of the biggest blind spots in spreadsheet-based budgeting. Your budget shows two numbers: what you planned to spend and what you've actually paid. It doesn't show what you've committed but haven't paid yet.
When you issue a purchase order for $18,500 in ductwork, that money is spoken for. But until the invoice arrives and someone enters it in the actual cost column, the spreadsheet still shows $18,500 of "remaining budget" in that category. Your remaining budget is overstated by every outstanding PO, every subcontractor commitment, and every material order that hasn't been invoiced yet.
On a commercial project with multiple equipment orders, two or three subs, and material deliveries spread across months, committed-but-not-yet-invoiced costs can easily represent 20-30% of your total project budget at any given time. The spreadsheet can't distinguish between "money we haven't spent yet" and "money that's already committed." That's a dangerous gap when you're trying to make decisions about whether you have room in the budget for additional scope or whether a cost overrun in one phase can be absorbed by savings in another.
3. Labor Budgeting Is Disconnected from Crew Scheduling
You budget 280 hours of journeyman labor for rough-in at $72 an hour. That number goes into the spreadsheet. Then your foreman schedules crews, assigns people to the job, and tracks hours in a completely separate process, whether that's timesheets, a time tracking app, or a whiteboard in the shop. Nothing ties the budget to the project schedule or to actual hours worked.
The spreadsheet has no idea how many of those 280 hours have been used. It has no idea who worked on the project last Tuesday or how many hours they logged. You find out your labor budget is in trouble when someone manually tallies the timesheets and enters a number in the actual cost column — which might happen weekly, might happen at the end of a phase, or might not happen until the job is nearly complete.
By then, the overrun is already baked in. You can't pull a crew member off the job retroactively. You can't un-spend the overtime. The spreadsheet told you nothing while the overrun was developing, because the data that would have flagged it lives in a different system entirely.
4. The Budget Doesn't Adapt as the Job Changes
A construction project budget at kickoff reflects the original scope. But scope changes are a normal part of both commercial and residential construction work. A GC-directed change order adds an exhaust fan. A field condition requires duct rerouting. The owner adds a mini-split to a break room that wasn't in the original plans.
Each change order modifies the budget — but in a spreadsheet, those modifications are manual. Someone has to go back into the file, add rows, adjust the budget totals, and make sure the variance calculations are still measuring against the right baseline. If the change order also affects your schedule of values, that's a separate file that needs separate updates.
On a project with four or five change orders across different phases, keeping the spreadsheet reconciled is its own project. And because it depends entirely on someone remembering to do it, and doing it correctly, the spreadsheet often lags behind the actual state of the work. Your budget says one thing, your contract says another, and your billing documentation says a third.
5. No Way to Compare Budget Performance Across Projects
If you're running four active jobs, you have four separate spreadsheets. If you want to know which projects are on track and which are at risk, you need to open each file, check the current state (assuming it's been updated recently), and manually piece together a picture of your overall financial position.
There's no consolidated view. There's no way to see that your rough-in labor consistently runs 8-12% over budget across projects — which would tell you something specific about your estimating assumptions. There's no way to compare material cost performance by supplier, or to see that one project manager consistently brings jobs in under budget while another doesn't.
That pattern-level visibility is what turns project budgeting from a per-job bookkeeping exercise into something that actually improves your profit margins over time. A Gantt chart can show you what's scheduled. A construction schedule template can track milestones. But a spreadsheet-per-project budget can't give you cross-project financial visibility without significant manual work, and that work is already stale by the time it's done.
How ServiceTitan Handles Construction Budgeting (and Solves These Issues for Specialty Contractors)
ServiceTitan's construction management software handles project budgeting as a connected part of your job costing and project management workflows. The budget lives inside the same system that manages your estimates, purchase orders, timesheets, change orders, and billing.
Your Estimate Becomes Your Budget Automatically
When you build a construction estimate in ServiceTitan, those line items don't get re-entered into a separate budget file. The estimate flows directly into the project budget. Cost codes, quantities, unit costs, and category breakdowns carry over automatically.
That means the budget your PM is managing during the job matches exactly what was estimated during pre-construction. No re-keying, no version mismatches, and no risk that someone mistyped a number during a manual budget setup. When the estimate changes during bid negotiations or scope refinement, the budget reflects those changes without a separate reconciliation step.
You can also build estimates from pricebook items with current material and labor rates. When copper pricing shifts between estimate and project kickoff, the pricebook reflects current costs. A spreadsheet budget still reflects whatever numbers were manually entered months ago.
Committed and Actual Costs Are Visible in the Same View


When you create and send a purchase order to a vendor in ServiceTitan, the committed cost posts against the project budget immediately. You don't wait for the invoice to arrive. You can see, at any point during the project, how much has been budgeted, how much is committed via POs, how much has been invoiced and paid, and how much is truly uncommitted.
That distinction between committed and spent is what lets you make real decisions mid-project. When a change order adds scope and you need to know whether you have budget room to absorb it, you need to know your actual remaining budget after accounting for every PO you've already issued. ServiceTitan shows you both numbers without anyone having to calculate the difference by hand.
Labor Costs Update as Crews Log Time
When a crew member clocks in and logs hours against a project using the ServiceTitan mobile app, those labor costs hit the project budget in real time. You don't wait for a foreman to submit a timesheet, for someone in the office to tally it, and for a third person to enter the total into a spreadsheet.
If rough-in labor is trending over budget at 60% of the way through the phase, you see that while there's still time to adjust crew size, shift resources, or have a conversation with the foreman about productivity. The budget and the project schedule are looking at the same data, updated from the same source.
This also means your labor cost data is accurate at the crew member level. When a project comes in over budget on labor, you can trace it to specific people, specific days, and specific phases. That visibility feeds better labor estimates on the next job.
Change Orders Update the Budget and the Billing Structure
When a change order is processed and approved in ServiceTitan, it automatically updates the project budget and the schedule of values. The budget vs. actual view reflects the revised contract scope. Your variance calculations are measuring performance against the current agreement, not the original estimate that no longer matches the work being done.
This matters because change orders on commercial projects can accumulate fast. A system that requires manual reconciliation every time scope changes is a system that's almost always behind. In ServiceTitan, the budget stays current because it's connected to the same workflows that process the change orders.
And the downstream impact is handled automatically. When you generate a progress billing payment application, the schedule of values already reflects approved change orders. Your billing matches the current contract without additional reconciliation. You get paid faster, and general contractors get the documentation they need.
Portfolio Visibility and Cost Reporting Across All Active Projects


ServiceTitan's project portfolio gives you a live view of every active project in one place, including status, invoicing, payments due, and budget information, without opening a separate file for each job. For a project manager or owner running multiple simultaneous jobs, that's how you catch problems early. You can see which projects are on track and which need attention without cross-referencing update dates or building a manual rollup.
For a deeper look at cost and margin performance, job costing reports let you compare material, equipment, purchase order, and labor costs against revenue for any project or group of projects, expressed in dollars and as a percentage of sales. Run the report on demand or schedule it to deliver on a recurring basis, filtered by date range or business unit. That gives you the ability to see, for example, whether your labor costs are consistently running high as a percentage of sales across every tenant improvement job in a given quarter, not just on the one project you happen to be reviewing.
That kind of cross-project visibility is what turns cost tracking from a reactive, per-job exercise into something that actually protects and grows your profit margins over time.
Portfolio and cost data both connect to WIP reporting, which calculates recognized revenue across active projects using the percentage-of-completion method. The financial data driving your WIP report is the same data driving your project costs, pulled automatically from project financials rather than entered by hand in a separate spreadsheet.
Connected to the Rest of Your Project & Financial Management Workflows
The budget in ServiceTitan isn't a standalone report. It's connected to the workflows that run across the entire life of a construction project.
Your construction estimate flows into the project budget at kickoff. As you create and send purchase orders to vendors, those costs post against the budget in real time. When your crew logs time in the mobile app, labor costs update automatically. When a change order is approved, the budget adjusts. When you generate a progress billing payment application, the continuation sheet is populated from the same cost structure, with current pricing and accurate line items.
All of this gives your team, from the PM in the office to the owner reviewing financials, a consistent, accurate view of where every job stands. Projected versus actual costs, estimated costs versus committed costs, budget versus contract value. No one has to manually compile that picture from disconnected spreadsheets and time tracking apps.
And when payments come in, they sync to your accounting platform, whether you're running QuickBooks, Sage, or Viewpoint. Your financial data stays consistent across systems without manual double entry.
Beyond Project Management: A Platform to Support the Entire Install-to-Service Lifecycle


One of the more significant structural advantages ServiceTitan offers contractors is the connection between construction and service in a single platform.
When an installation project closes out, the installed equipment and service history don't need to be re-entered in a separate system. Warranty periods, service agreements, and preventative maintenance schedules can be built directly from project closeout, so your installed base automatically becomes your service base.
This matters because the recurring revenue that comes from long-term service agreements on installed equipment is often the most profitable part of a contractor's business. Platforms that only handle the construction side of the job require a separate field service management solution, which creates data gaps, potential billing issues, and customer attrition when handoffs go wrong.
Get a Personalized Demo of ServiceTitan Construction Software
What we've covered above is part of how ServiceTitan helps specialty subcontractors in HVAC, plumbing, electrical, and other trades manage construction budgeting without the overhead of disconnected spreadsheets and manual reconciliation.
If you're interested in exploring other specific features and functionality, here are some places to start:
Field Mobile App (iOS & Android)
To see how ServiceTitan's job costing and project management tools work in practice, schedule a call for a live walk-through tailored to your business.
